Replatforming & Migration6 minute read

Replatforming Timelines by Complexity Tier

An enterprise Shopify replatform usually takes three to five months for an established brand with a few integrations, and six months or more for a multi-brand or ERP-integrated estate. A simple single-storefront move can take six to ten weeks. Four factors decide where you land: integration count, custom functionality, data cleanliness, and decision speed. Revenue size isn't one of them.

Last verified Published Last updated

What actually determines how long a replatform takes?

1. Integration count. Each system the new platform needs to talk to — ERP, OMS, WMS, CRM, subscription platform, tax, shipping — adds real time. Not linearly, either: integrations interact with each other in ways that compound complexity beyond the sum of individual connections. Two systems that both need to be the source of truth for inventory is a design problem, not two connection tasks.

2. Custom functionality with no native equivalent. Every feature rebuilt rather than retired is real development time. This is where a feature-parity audit directly buys back schedule: the fastest feature to build is the one you decided not to.

3. Data cleanliness. A catalog with years of accumulated inconsistencies — duplicate SKUs, inconsistent categorization, orphaned records, products that exist in three category trees with different attributes — takes longer to migrate cleanly than an equally large but well-maintained one. Volume is easy; inconsistency is expensive.

4. Internal decision-making speed. A single empowered decision-maker moves faster than a project requiring committee sign-off at every checkpoint. This is an organizational factor rather than a technical one, and on compressed timelines it's frequently the binding constraint.

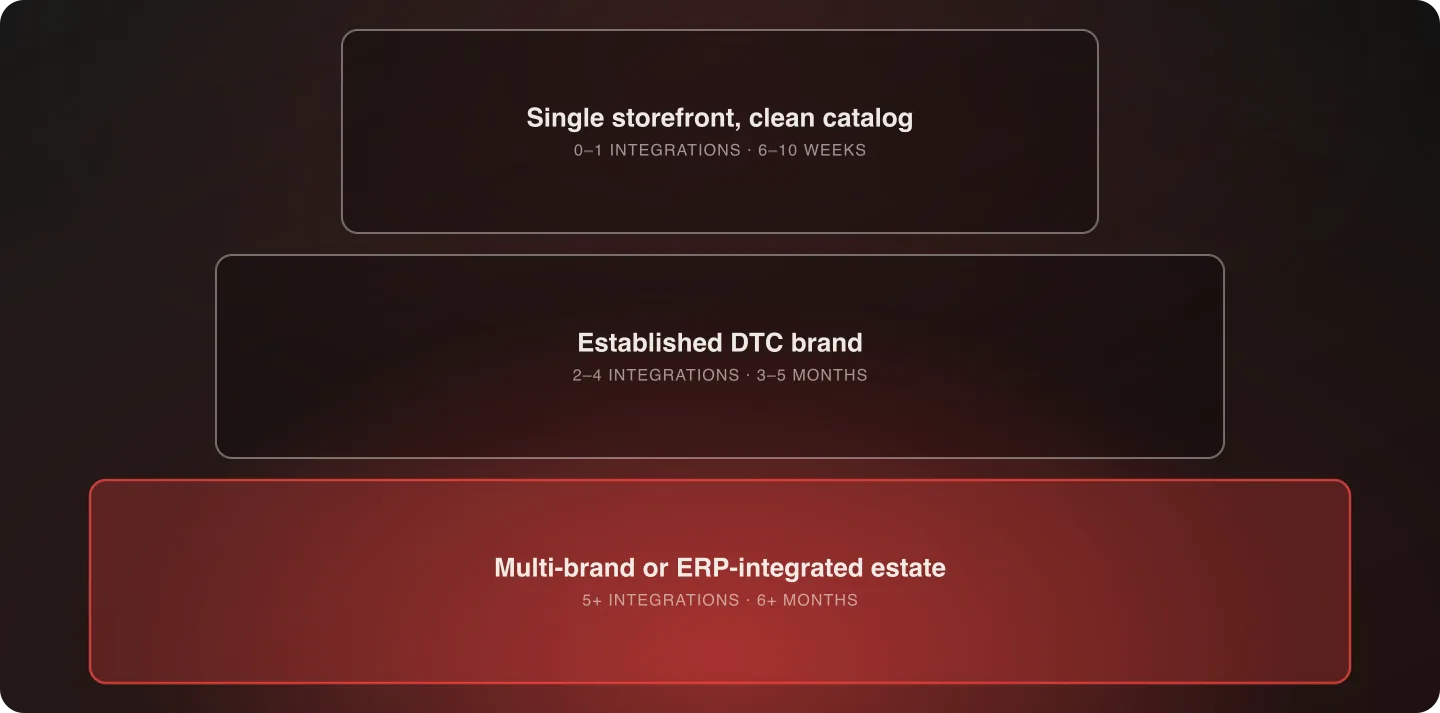

The four factors that determine how long a replatform takes: integrations, custom functionality, data cleanliness and decision speed
The four factors that drive a replatform timeline.

How long does each complexity tier take?

A low-complexity, single-integration replatform can move in six to ten weeks. A multi-integration, custom-functionality-heavy enterprise migration is more realistically measured in several months. Where a specific project lands depends on the four factors above, not on picking a number from a table. A merchant already on Shopify replacing only the theme isn't replatforming at all — a Horizon migration of an existing Shopify store runs four weeks at a fixed price, because the catalog, customer data and back-office integrations stay where they are.

How the four factors shift a timeline. Indicative ranges as of September 2026, not a quote.
ProfileIntegrationsCustom functionalityIndicative range
Single storefront, clean catalog0–1Minimal, mostly native6–10 weeks
Established DTC brand2–4Subscriptions, loyalty, a custom flow or two3–5 months
Multi-brand or ERP-integrated estate5+Custom OMS/WMS logic, bespoke builders6+ months

Treat that table as a way to locate your own project relative to others, not as a commitment. The same three profiles can move faster or slower by a wide margin depending on data cleanliness and decision speed, neither of which appears in the columns.

Is 31 days a realistic replatform timeline?

That timeline is real, and it reflects a specific profile: defined scope, strong internal readiness, focused priorities, and a decision-making structure that could keep pace. Use it as evidence the method can move fast when the four factors are favorable — not as a timeline to demand regardless of your own profile. The full story is more instructive for what didn't get cut to hit the date than for the date itself.

What actually shortens a replatform timeline?

Three things genuinely compress a replatform: reducing scope through a feature-parity audit, resolving data quality issues before migration rather than during, and empowering a single internal decision-maker. All three are decisions made before the build starts.

Two things appear to compress it and don't: adding developers to a project whose constraint is decision latency, and deferring testing disciplines to post-launch. The second is the more expensive illusion — it moves work past the launch date rather than removing it, and the work costs more on the other side. Pre-launch UX testing is the discipline most often sacrificed this way.

The two documented ends of Anatta's own range: buybuy BABY at 31 days with a defined scope and an external deadline, and Nuts.com at six months for a nine-year commercetools build carrying subscriptions and five custom product builders. The difference between them is complexity, not effort.

Which phase of a replatform takes the longest?

Timeline conversations tend to focus on the build, which is rarely the longest phase. A more accurate mental model, as proportions of the whole:

Roughly where a replatform's calendar time goes
PhaseShare of the scheduleWhat decides it
Discovery and scoping15–25%Integration count, and how quickly internal answers arrive
Data profiling and remediation10–20%How clean the catalog and customer records actually are
Build and integration30–40%Custom functionality that has no native equivalent
Testing, UX review and rehearsal15–25%Whether these run in parallel with build or after it
Cutover and stabilization5–10%Rehearsal quality, and how much is deferred to post-launch

Two things fall out of that table. First, more than half the calendar sits either side of the build, which is why adding developers to a late project so rarely helps. Second, the testing phase is the one most often compressed under deadline pressure, and it's the compression that converts a schedule problem into a revenue problem after launch.

Free, no call required

Trying to set a launch date?

Get a free written read of what is most likely to move it.

Does Agentic Delivery change these ranges?

Partly, and in specific places. Agentic Delivery compresses the phases that are execution: build and integration, and testing and rehearsal, which together are roughly half the schedule. It doesn't compress the phases set by people and data: how quickly internal decisions arrive, and how clean the catalog and customer records are. That's why a project like a Horizon theme migration can move from months to weeks (Dropps shipped a rebrand and a catalog rebuild in four weeks), while an ERP-integrated replatform still runs on the timeline its decisions and data allow. When Agentic Delivery shortens a specific estimate, the estimate should say which phase it shortens.

How should you estimate a replatform timeline?

Estimate the four drivers separately rather than the project as a whole, then assemble. Count the integrations and price each one, including the ones that interact. Count the custom features surviving a feature-parity audit, not the ones on the current site. Profile the data before estimating its migration rather than after. And be honest about the decision structure — a project needing committee sign-off at each checkpoint should carry a larger contingency than one with a single empowered owner, because the delay is structural rather than occasional.

Then give the number as a range with the drivers named. A point estimate for a project with four independent sources of variance is a guess wearing a suit, and everyone in the room knows it.

When should a replatform start?

Duration is one question; when the window sits is another. A four-month project starting in August lands its cutover in peak season for most retail categories, which changes the risk profile substantially — see replatforming during peak season. Work backwards from the date you want to be live and stable, not forwards from the date you want to start.

Realistic timelines are the seventh of the seven disciplines in Anatta's replatforming method.

Frequently Asked Questions

How long does an enterprise Shopify replatform take?

Three to five months for an established brand with a few integrations, and six months or more for a multi-brand or ERP-integrated estate. A simple single-storefront move can take six to ten weeks. Integration count, custom functionality, data cleanliness, and decision speed decide where a project lands, not revenue size.

Is buybuy BABY's 31-day migration a realistic timeline to expect?

Only for a similarly-scoped project with similarly favorable readiness factors. It's proof the method can move fast under the right conditions, not a universal benchmark.

Does revenue size predict how long a replatform takes?

No. A high-GMV single-storefront brand with a clean catalog and two integrations moves faster than a smaller multi-brand estate with custom OMS logic. Complexity drives timeline; revenue doesn't.

What actually shortens a replatform timeline?

Reducing scope through a feature-parity audit, resolving data quality issues before migration rather than during, and empowering a single internal decision-maker. Adding developers to a project constrained by decision latency does not.

Which phase of a replatform takes the longest?

Build and integration is the largest single phase at roughly 30–40%, but more than half the calendar sits either side of it — discovery, data profiling and remediation before, testing and cutover after. That's why adding developers to a late project rarely helps.

How should a replatform timeline be estimated?

By estimating the four drivers separately and assembling, rather than estimating the project as a whole: integrations counted and priced individually, custom features counted after a feature-parity audit, data profiled before it's estimated, and a larger contingency where sign-off requires a committee.
